Progress MS-18 docks at Zvezda

Launched in the early hours of October 28, 2021, the Progress MS-18 cargo ship embarked on a two-day trip to the International Space Station, ISS, concluding with a docking at the aft port of the Zvezda Service Module. That particular docking mechanism was unoccupied for half a year, because it is connected to the rest of the outpost via the PrK transfer compartment which had been leaking air despite all efforts to seal tiny cracks in its walls. (INSIDER CONTENT) Progress MS-18 should confirm that the PrK chamber could be used safely.


Previous mission: Progress MS-17

Bookmark and Share

pad

Progress MS-18 mission at a glance:

Spacecraft designation(s) Progress MS-18, No. 447, ISS mission 79P
Launch vehicle Soyuz-2-1a (14S53 0000A1-0) No. S15000-049
Payload fairing 11S517A2.1000A1-0
Launch site Baikonur, Site 31, Pad 6
Mission Cargo delivery to the ISS
Launch date and time 2021 Oct. 28, 03:00:32.525 Moscow Time
Docking date and time 2021 Oct. 30, 04:33 Moscow Time
Docking destination ISS, Russian Segment, Zvezda Service Module, SM, aft port
Mission duration 216 days
Undocking and reentry 2022 May
Spacecraft mass ~7.4 tons
SUPPORT THIS PROJECT!
Donate

Progress MS-18 mission

According to Roskosmos, Progress MS-18 will deliver around 1,490 kilograms of supplies to the ISS, including 560 kilograms of propellant for refueling the station, 420 liters of water in the tanks of the Rodnik system and 43 kilograms of compressed air in the tanks of the oxygen supply system. In its pressurized cargo section, the spacecraft will carry dry cargo for the crew and equipment for ongoing scientific studies including experiments Matreshka-R, Biomag-M, Aseptik, Struktura and Fotobioreaktor.

During the early planning of the ISS flight manifest in 2014, the second Russian cargo mission of 2021 was planned for April 16, 2021, however in the provisional schedule prepared by Roskosmos at the end of August 2020, the launch of Progress MS-18 (ISS mission 79P, Production No. 447) was planned for August 18, 2021. By November 2020, the start of the mission slipped to October 28, 2021.

At the time, the vehicle was expected to dock at the aft port of the Zvezda Service Module, SM, and remain in orbit for 215 days, supporting the 66th long-duration expeditions aboard the ISS. That schedule remained unchanged until the launch.

Progress MS-18 launch campaign

The Soyuz-2-1a rocket for the Progress MS-18 mission arrived at Baikonur in the middle of August 2021. On September 1, Roskosmos announced that the cargo ship had been taken out of storage inside processing complex at Site 254 and installed in its testing rig, where specialists conducted visual inspection of the spacecraft in preparation for electric checks scheduled to begin on September 2.

The autonomous tests of the spacecraft's radio systems in the anechoic chamber were completed on September 23 and on September 28, the spacecraft was transported into the vacuum chamber for air leak checks, which were completed by October 4, when the spacecraft was returned to its processing facility at Site 254.

progress

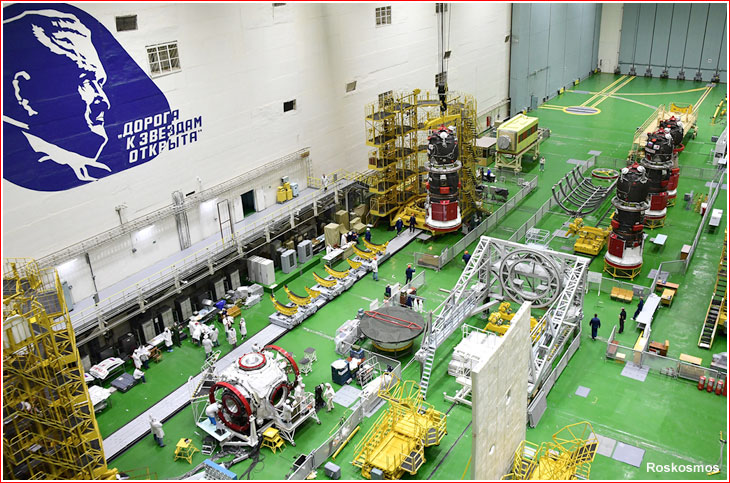

Progress MS-18 (top center) returns to its processing facility on October 4, 2021, after the completion of vacuum tests.


The mechanical assembly of the first and second stages of the Soyuz-2-1a launch vehicle for the mission was performed at Site 31 by October 8. On the same day, specialists conducted routine tests of the cargo ship's solar panels, tested the lines of the ship's Rodnik water-supply system. On October 15, a meeting of technical management cleared Progress MS-18 for fueling of its propulsion unit and of the re-fueling section. Prior to its departure to the fueling station, the spacecraft undewent balancing and weighting at Site 254. Also, on October 15, specialists at the vehicle assembly building at Site 31 completed the four-day process of pneumatic tests on the three stages of the Soyuz-2-1a rocket and transitioned to autonomous tests of the rocket's systems.

The fueling operations with Progress were completed by October 19, after which, the cargo ship was returned to its processing stand at Site 254. On October 20, the spacecraft was integrated with an adapter section serving as an interface with the launch vehicle. The stack was then lowered in horizontal position, rolled inside its payload fairing and, on October 22, the assembled payload section was loaded into a rail transporter and shipped to the vehicle assembly building for integration with its rocket which was completed on October 23.

rollout

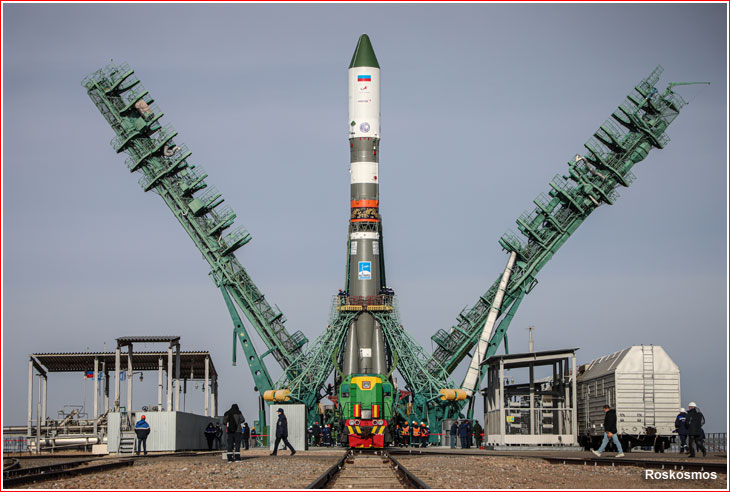

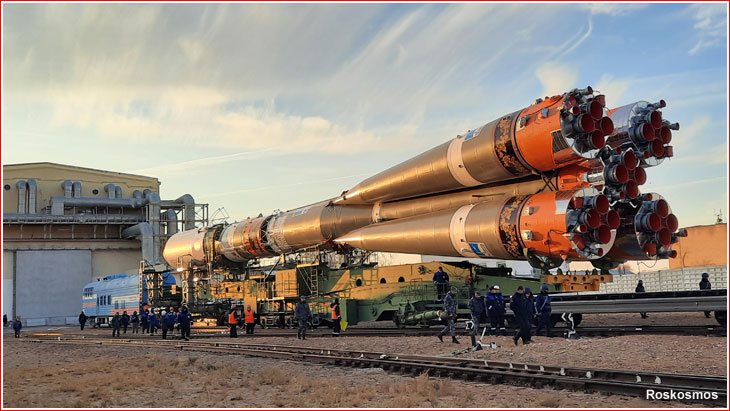

The launch vehicle was rolled out to the launch pad on the morning of Oct. 25, 2021.

Progress MS-18 launch profile

A Soyuz-2-1a rocket carrying the Progress MS-18 cargo ship lifted off from Site 31 in Baikonur on Oct. 28, 2021, at 03:00:32.525 Moscow Time (8 p.m. EDT on October 27).

orbit

Following vertical liftoff under the combined thrust of the four RD-107 engines on the first stage and the single RD-108 of the second (core) stage, the launch vehicle headed eastward from Baikonur matching its ground track to an orbit inclined 51.67 degrees to the plane of the Equator. The four first-stage boosters separated nearly two minutes into the flight, followed by the split and drop of the two halves of the payload fairing slightly more than a minute later. In the meantime, the second stage continued firing until 4.7 minutes into the flight.

The third stage ignited moments before the separation of the second stage, firing its RD-0110 engine through a lattice structure connecting the two boosters and ensuring a continuous thrust during the separation process. A fraction of a second after the boosters of the second and third stage parted ways, the aft cylindrical section of the third stage split into three segments and dropped off, ensuring the fall of the second stage and the aft section into the same drop zone.

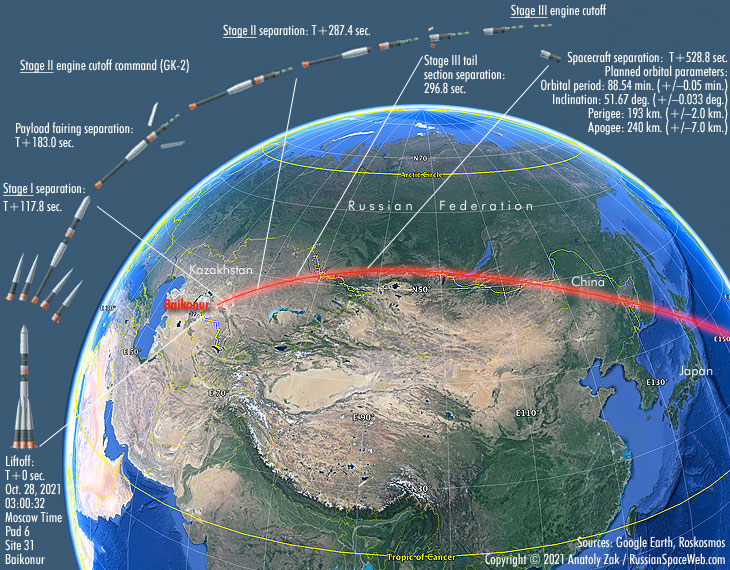

The spacecraft was expected to separate from the third stage of the launch vehicle 8 minutes and 49 seconds after liftoff into a 193 by 240-kilometer orbit with an inclination 51.67 degrees toward the Equator.

Rendezvous and docking

approach

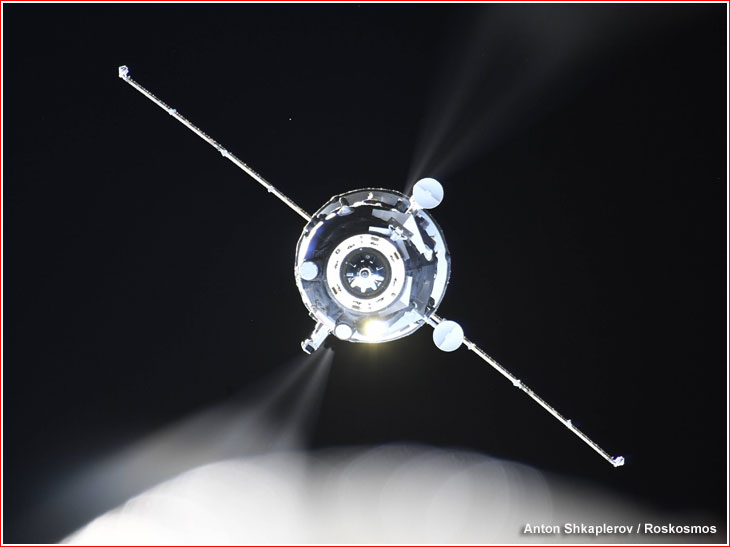

The Progress MS-18 mission followed a two-day rendezvous profile with the ISS. Its docking at the aft port of the Zvezda Service Module was scheduled for Oct. 30, 2021, at 04:33 Moscow Time (9:33 p.m. EDT on October 29) with three-minute accuracy. The actual physical contact between the cargo ship and the station was registered at 04:31:19 Moscow Time on October 30 (9:31 p.m. EDT on October 29).

It was the first spacecraft docking at the aft port of the Zvezda Service Module since the departure of Progress MS-14 on April 28, 2021. During that period, the PrK transfer chamber connecting the port to the Zvezda's interior, remained closed off to mitigate an air leak in its walls (INSIDER CONTENT).

Progress MS-18 to help ISS to avoid space junk

On November 10, Roskosmos announced that Progress MS-18 cargo ship was scheduled to fire its engine for 361 seconds starting at 23:15 Moscow Time (3:15 p.m. EST), increasing the station's velocity by 0.7 meters per second and boosting its average altitude by 1,240 meters to 420.72 kilometers. According to the State Corporation, the maneuver, designed to avoid space junk, went as scheduled.

Several hours earlier, Roskosmos said that the ISS had been predicted to pass close to a fragment of the Fengyun-1C satellite around 04:00 Moscow Time on November 12 (8 p.m. EST on November 11). Fengyun-1C satellite was destroyed in 2007 in a test of a Chinese anti-satellite missile.

Previously, an orbit correction using Progress MS-18's propulsion system was planned to be initiated on Nov. 16, 2021, at 20:40 Moscow Time. The maneuver was scheduled to last 478 seconds, Roskosmos said on November 8. However, on November 11, Roskosmos announced that the orbit correction originally planned on November 16 had been cancelled, because the space-junk-avoidance manuever conducted on November 10 was designed to provide necessary orbital parameters for the station.
