Progress MS-31 to re-supply ISS

The second Russian mission to resupply the International Space Station, ISS, lifted off from Baikonur Cosmodrome in Kazakhstan, on July 3, 2025. The Progress MS-31 cargo ship is on a two-day rendezvous trip to the orbital outpost to deliver propellant and cargo to the Expedition 73 crew.

Previous cargo mission: Progress MS-30

ignition

Progress MS-31 mission at a glance:

Spacecraft designation(s) Progress MS-31, 11F615 No. 461, ISS mission 92P
Launch vehicle Soyuz-2-1a, 14S53 No. M15000-048
Payload fairing SZB: 11S517A2.1000A1-0 No. M15000-141
Launch site Baikonur, Site 31, Pad 6
Mission Cargo delivery to the ISS' Expedition 72
Launch date and time 2025 July 3, 22:32:40.257 Moscow Time (actual)
Docking date and time 2025 July 6, 00:27 Moscow Time (planned)
Docking destination ISS, Russian Segment, Poisk (MIM2)
Deliverable payload mass 2,599 kilograms
Flight duration ~6 months (planned)
SUPPORT THIS PROJECT!
Donate

Progress MS-31 cargo mission

According to Roskosmos, Progress MS-31 was scheduled to deliver more than 2,600 kilograms of cargo to the station. It included more than 540 kilograms of hardware and equipment, as well as various materials for the following experiments: Impuls, Mirazh, Biopolymer, Virtual, Fulleren, Splankh, Biodegradatsiya, Orbita-MG and Separatsiya.

The dry cargo also included 317 kilograms of personal supplies for the members of Expedition 73, such as clothing, medical and hygiene materials, as well as 344 kilograms of food. All this cargo was loaded into the pressurized forward compartment of the vehicle.

At the same time, the cargo ship's tanker module was filled with 950 kilograms of propellant for refueling (INSIDER CONTENT) the station's propulsion system (INSIDER CONTENT), 420 kilograms of drinking water and 50 kilograms of compressed nitrogen for replenishing the atmosphere of the ISS, Roskosmos said.

Roskosmos assigned the Progress MS-31 mission to the Soyuz-2-1a No. 075 rocket, which was originally procured for the commercial launch of the second CAS-500 remote-sensing satellite for South Korea. For promotional purposes, the State Corporation's commercial arm, Glavkosmos, had ordered the rocket to be painted mostly white, apparently because its executives erroneously believed that such a paint scheme had been used on the Vostok rocket which launched the first human into space in 1961. The rocket was stuck on the ground after South Korea cancelled the deal as a result of Russia's full-scale invasion of Ukraine in 2022.

According to the ISS flight manifest in 2024, the launch of Progress MS-31 was expected on May 28, 2025, but before the end of that year, the mission shifted to July 3, 2025.

Progress MS-31 launch campaign

ms31

On March 14, 2025, RKK Energia reported that the Progress MS-31 spacecraft had completed its factory tests and been shipped to Baikonur by rail. It reached the launch site four days later.

The active launch campaign for Progress MS-31 in Baikonur started in mid-May 2025, when specialists placed the spacecraft into the anechoic chamber within the processing complex at Site 254 for radio tests. The operation was completed on May 15. On May 29, 2025, Roskosmos reported the successful completion of tests in the vacuum chamber which were started on May 23. Progress MS-31 entered the irreversible phase of the launch campaign with the start of propellant components and pressurized gases loading on June 22, 2025.

On June 27, the cargo ship was mounted on its launch vehicle adapter designed to serve as an interface with its Soyuz-2-1a rocket. On June 29, specialists conducted traditional visual inspection of the spacecraft and then lowered it into horizontal position and rolled it into the payload fairing. The resulting assembly was then returned into vertical position for final tests. The stack was then lowered again, loaded into a rail transporter and moved to the Vehicle Assembly Building at Site 31 for the final integration with the launch vehicle. The assembly process was completed on June 30, 2025.

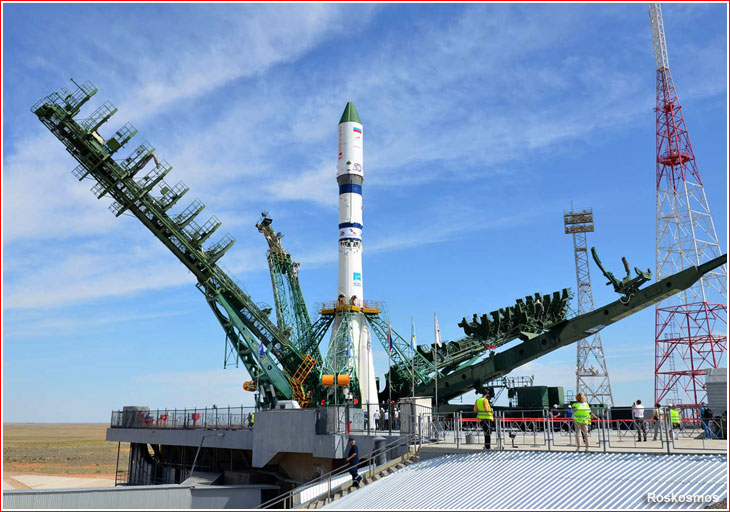

The rocket with the spacecraft was rolled out to the launch pad at Site 31 on the morning of July 1, 2025.

Progress MS-31 launch profile

pad

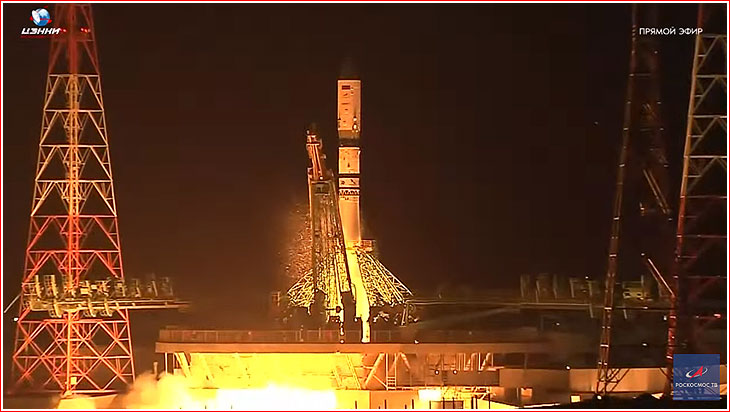

A Soyuz-2-1a rocket, carrying the Progress MS-31 cargo ship, lifted off from Pad 6 at Site 31 in Baikonur on July 3, 2025, at 22:32:40.257 Moscow Time (3:32 p.m. EDT).

Following a vertical liftoff under the combined thrust of the four RD-107 engines on the first stage and the single RD-108 of the second (core) stage, the launch vehicle headed eastward from Baikonur matching its ground track to an orbit inclined 51.67 degrees to the plane of the Equator.

The four first-stage boosters separated 1 minute 58 seconds after liftoff, at an altitude of around 43 kilometers, followed by the split and drop of the two halves of the payload fairing slightly more than a minute later at an altitude of around 91 kilometers, just above the dense atmosphere and around 200 kilometers downrange. In the meantime, the second stage continued firing until 4 minutes and 47 seconds into the flight, bringing the vehicle to around 143 kilometers above the planet and a speed of around four kilometers per second, some 500 kilometers downrange from the launch site.

The third stage ignited moments before the separation of the second stage, firing its RD-0110 engine through a lattice structure connecting the two boosters and ensuring a continuous thrust during the separation process. A fraction of a second later, the boosters of the second and third stage parted ways and the aft cylindrical section of the third stage split into three segments and dropped off, ensuring the fall of the second stage and the aft section into the same area on the ground.

The third stage completed firing its engine and released the cargo ship into an initial parking orbit 8 minutes 49 seconds after liftoff.

Progress MS-31 rendezvous profile

The Progress MS-31 mission will follow a two-day, 34-orbit rendezvous profile with the ISS. The cargo ship is slated to perform a fully automated docking with the Poisk module, MIM2, a part of the Russian Segment on July 6, 2025, at 00:27 Moscow Time (5:27 p.m. EDT on July 5).



insider content



This page is maintained by Anatoly Zak; last update: July 3, 2025

Page editor: Alain Chabot; last edit: July 3, 2025

All rights reserved



insider content



Progress

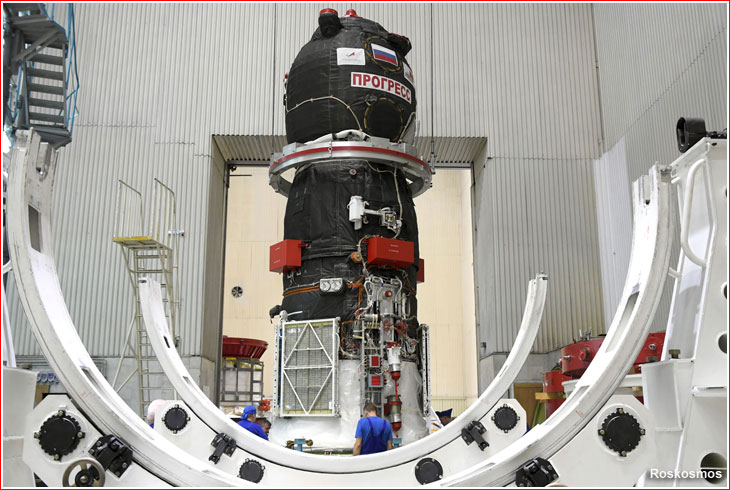

Progress MS-31 spacecraft is integrated with the launch vehicle adapter on June 26, 2025. Click to enlarge. Credit: Roskosmos
